Home / Blog / Solar

What a Solar Installation Actually Looks Like: From PV Combiner Box to COC

Panels are the visible part. The DC combiner, the breakers, the hybrid inverter, the battery, the changeover and the anti-islanding relay are what make a solar system safe and compliant. A photo walkthrough of a real installation.

Most people picture solar as panels on a roof. The panels are the easy part. What decides whether a system is safe, compliant and still working in ten years is everything between the roof and the DB board — the DC protection, the inverter, the battery, the changeover and the grid protection. Here is what a properly done installation looks like, step by step, using photos from our own East Rand installs.

1. Site assessment and design

Before anything is ordered we look at three things: your electricity usage (ideally from a year of bills or a smart meter), your roof — orientation, pitch, shading, and whether the structure and tiles are sound — and your DB board. The DB decides a surprising amount: an old board with no space, no earth leakage and unlabelled circuits needs to be sorted out before an inverter can be connected to it. From that we size the array, the inverter and the battery, and separate your circuits into what will run on solar/battery and what stays on the grid.

2. Panels and mounting

Panels are mounted on aluminium rails fixed through the roof covering into the rafters or purlins, with flashings sealed against leaks. On a tiled roof like the one below the tiles are lifted, the brackets fixed, and the tiles relaid. Panels are wired in series into “strings”, and the string voltage — often several hundred volts DC — is why the next step matters so much.

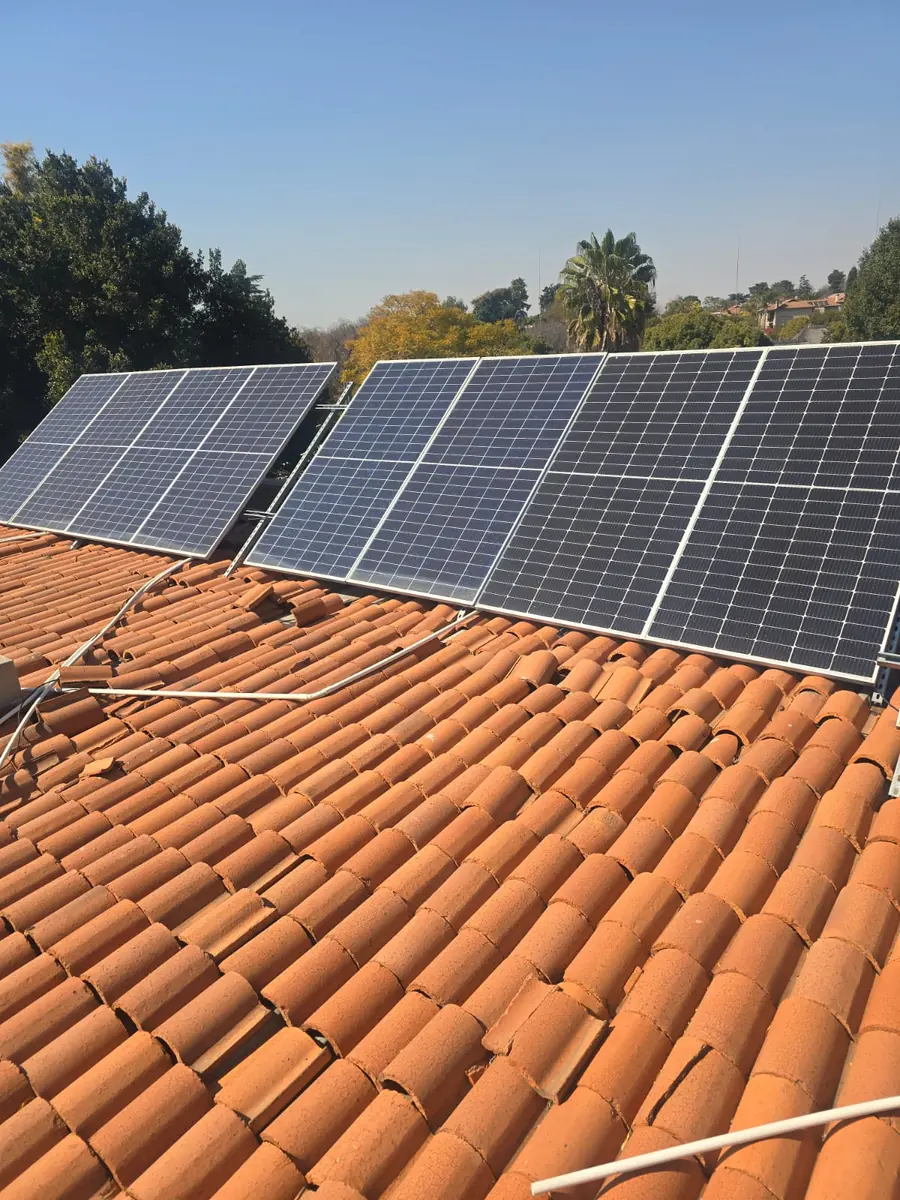

Solar panels mounted on the tiled roof of an East Rand home
Panels on a north-facing tiled roof. Mounting has to be watertight and strong enough for Highveld wind and hail, not just hold the panels flat.

3. DC protection: the combiner box and DC breakers

String cables come down into a PV combiner box. Here each string has its own fuse or breaker, there is a DC surge arrestor to protect the inverter from lightning-induced surges (the Highveld has some of the highest lightning activity in the world), and a DC isolator so the inverter can be worked on safely. Solar DC cannot be switched off at the panels while the sun is shining, so this box is the only place the installer can safely isolate the array.

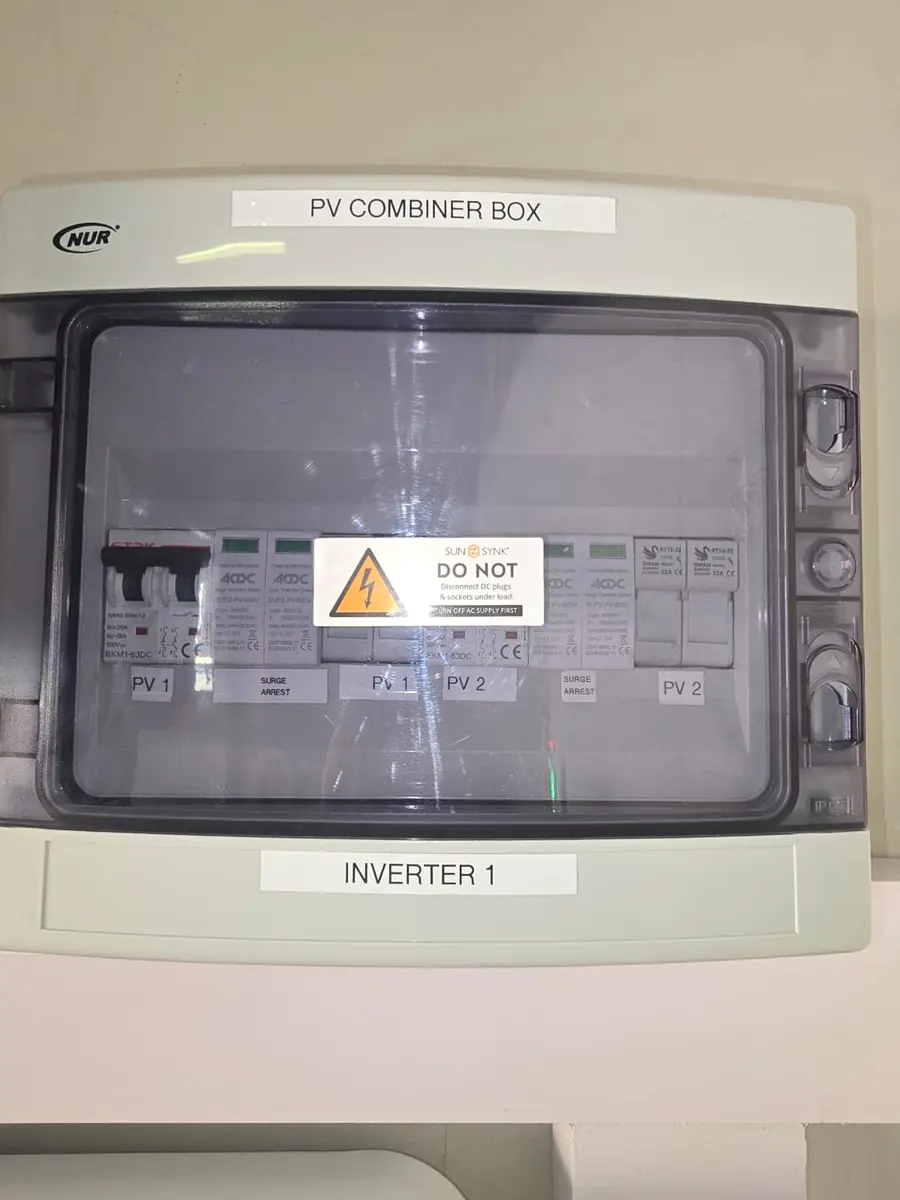

PV combiner box for a solar inverter with DC isolators, fuses and surge arrestors
A labelled PV combiner box: string breakers, surge arrestor and isolator for one inverter.

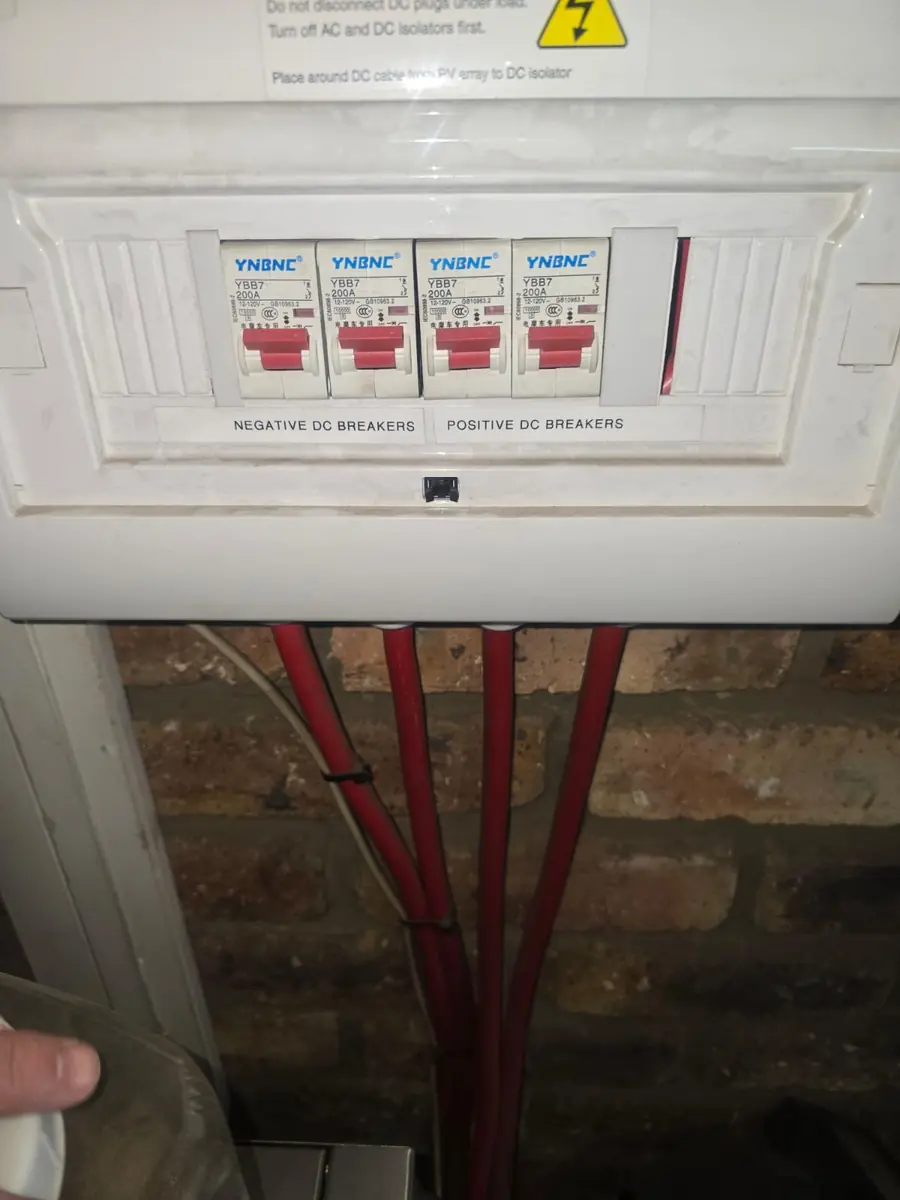

Positive and negative DC breakers for solar PV strings mounted in a wall enclosure
Positive and negative DC breakers for the strings, with the red DC cabling clearly separated from AC.

4. The hybrid inverter

The inverter is the brain of the system. A hybrid inverter such as the Sunsynk units we install takes DC from the panels, charges the battery, feeds the house, and manages the grid connection — all at once, according to the priorities you set (use solar first, hold a battery reserve for outages, and so on). On larger or off-grid-capable systems we also work with Victron equipment, which splits the same job across an MPPT charge controller, an inverter/charger and a monitoring gateway.

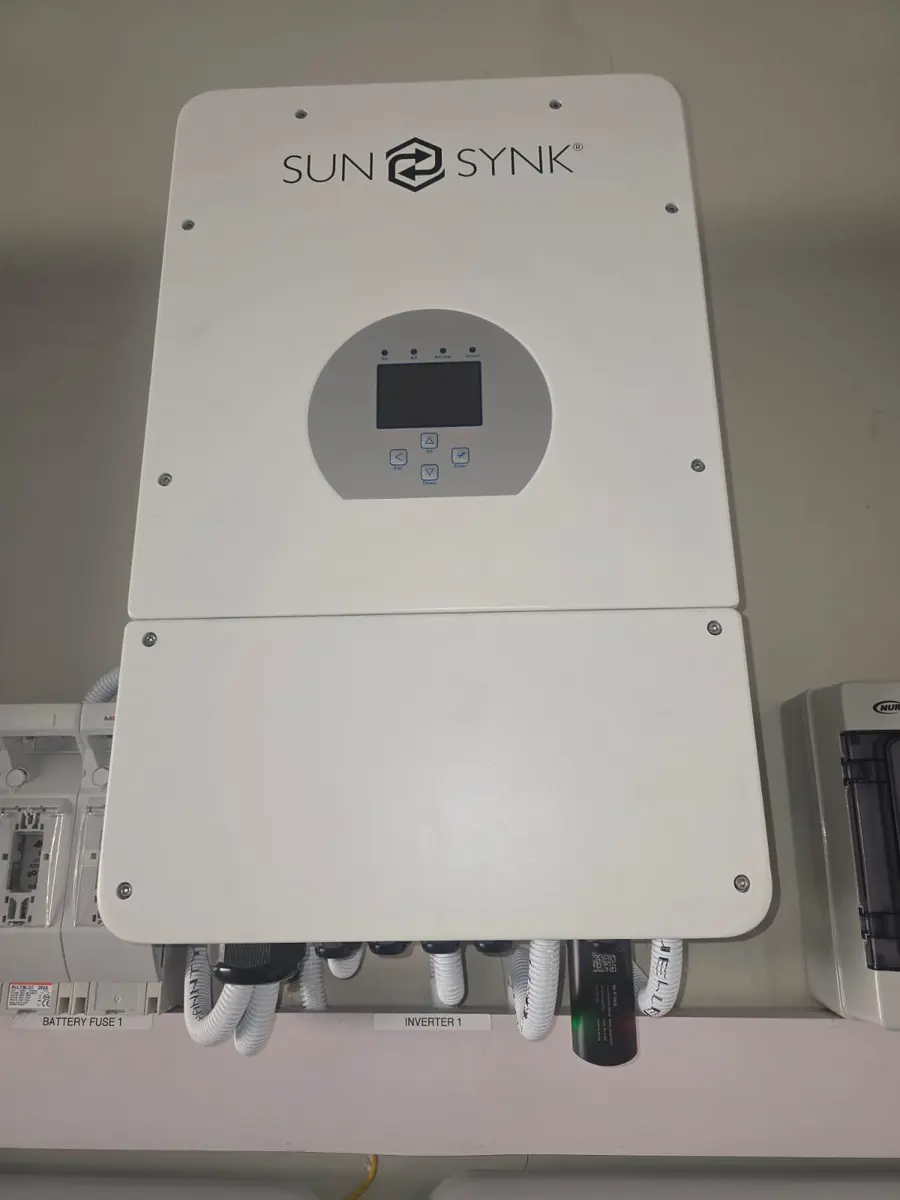

Sunsynk hybrid inverter wall-mounted with battery fuse and DC isolator below
A Sunsynk hybrid inverter mounted with its battery fuse and DC isolator below. Cable entries are glanded and the unit has clear space around it for cooling.

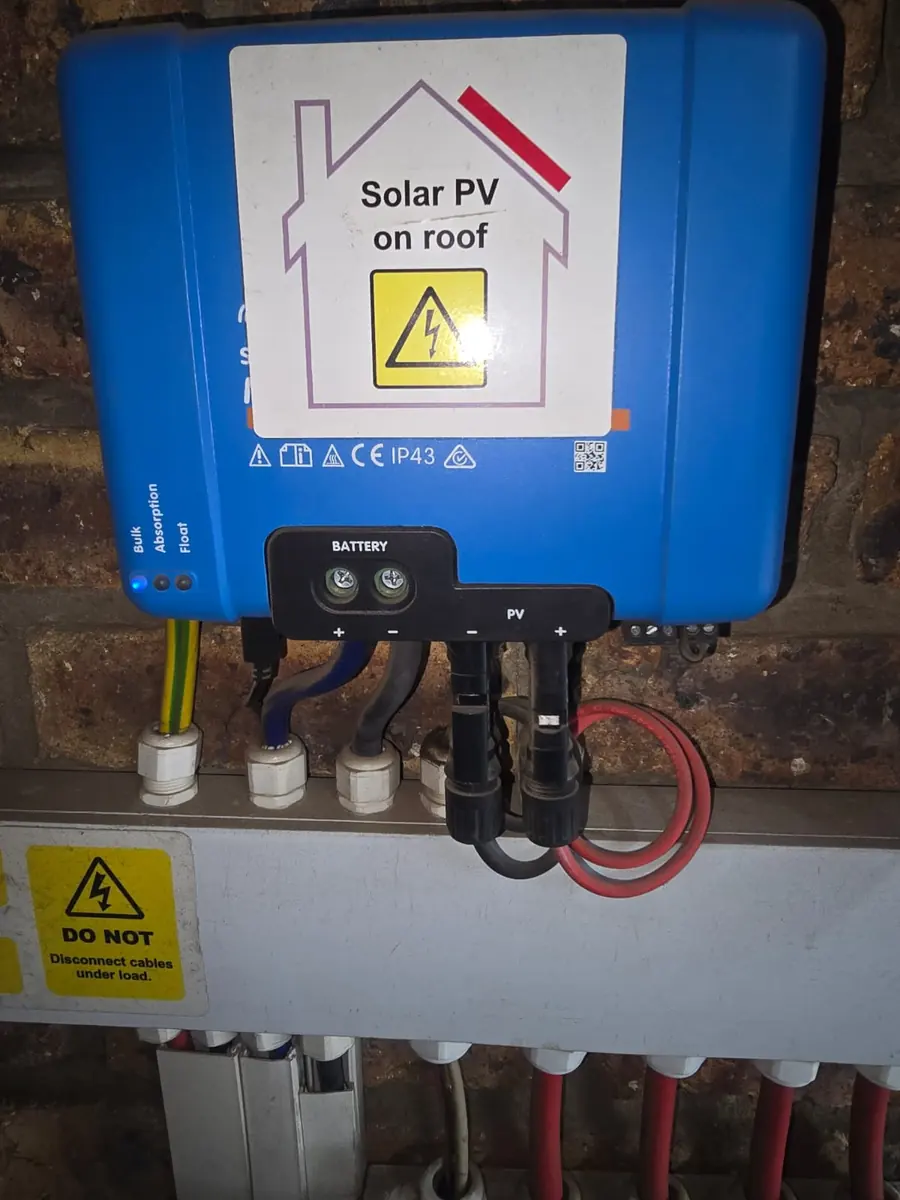

Victron SmartSolar MPPT charge controller with a 'Solar PV on roof' warning label
A Victron MPPT charge controller on a Victron-based system, with the required “Solar PV on roof” warning label.

Talk to the team that does this work

Free quotes, straight answers and SANS 10142-compliant workmanship across the East Rand and Sandton. Call, WhatsApp or request a quote online.

5. Battery storage

Lithium batteries — Hubble is a brand we use regularly — store solar energy for the evening and for outages. They communicate with the inverter over a data cable so the inverter knows the battery’s state of charge and limits, which is why the communication wiring in a solar installation gets the same care as the power cabling. Batteries are mounted with ventilation, fused on the DC side and kept away from heat.

Communication and monitoring cables connected to a hybrid inverter and battery system
Communication cabling between inverter, battery and monitoring. Get this wrong and the inverter cannot protect the battery.

6. AC side: changeover, essential circuits and the DB

On the AC side the inverter output feeds an essential-circuits section of the DB — lights, plugs, TV, routers, fridge — while heavy loads such as the geyser and stove stay on the grid. A changeover arrangement makes sure the inverter can never feed back into the grid during an outage, protecting municipal technicians. Surge protection goes on the AC side too. If the existing board is not up to it, this is the point where a DB board upgrade happens.

Labelled changeover box for a second inverter, with Eskom and inverter supply switches and surge protection
A changeover box for a second inverter on a larger home — Eskom in, inverter out, surge arrestor and clear labels.

Solar DC combiner box with surge arrestors and string isolators
A second combiner box on the same site. Larger homes often run two inverters, each with its own DC protection.

7. Grid connection, anti-islanding and SSEG registration

If the system is connected to the grid at all — and almost every hybrid system is — it must not be able to energise the municipal network when the grid is down. That is “anti-islanding”, and on grid-tied systems it is enforced by protection inside the inverter and, where the municipality requires it, by a separate anti-islanding relay that monitors grid voltage and frequency and disconnects the system outside the permitted window.

Grid-tied systems must also be registered with the municipality as small-scale embedded generation (SSEG). For most of the East Rand that is the City of Ekurhuleni; Johannesburg has its own process for Sandton and surrounds. Registration requires the installation to be certified, which brings us to the last step.

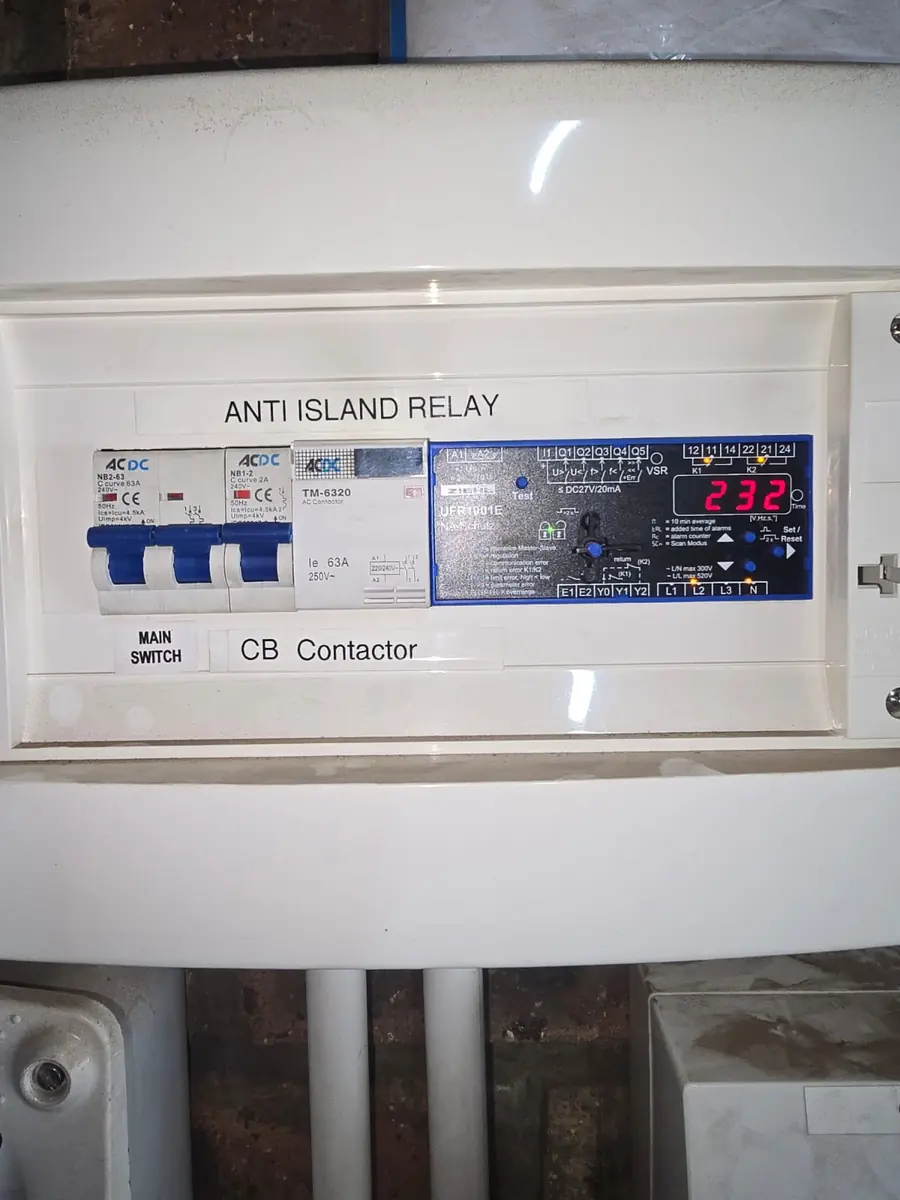

Anti-islanding relay and main switch on a grid-tied solar installation, showing 232 V grid voltage
An anti-islanding relay panel on a grid-tied system, showing grid voltage at 232 V. It disconnects the inverter if the grid goes outside limits.
Victron Venus GX enclosure with photovoltaic system and dual-supply warning labels
Warning labels are a compliance requirement, not decoration: anyone opening this enclosure must know there is a second supply that does not switch off with the mains.

8. Commissioning, monitoring and the COC

At commissioning we test string voltages and polarity, insulation resistance, earth continuity and earth-leakage operation on the backup side, set the inverter’s charge and grid parameters, and simulate a grid failure to confirm the changeover behaves. The inverter’s monitoring app is set up so you can see solar production, battery state and grid use from your phone.

Finally the installation is issued with a Certificate of Compliance. Solar is part of your fixed electrical installation under SANS 10142-1, and a system installed without a COC will cause problems with insurance, with SSEG registration and when you sell the property. Our guide to electrical COCs explains what the certificate covers.

Sunsynk inverter display showing solar, battery, load and grid readings
The inverter display after commissioning: solar production, battery, load and grid readings live on the panel.

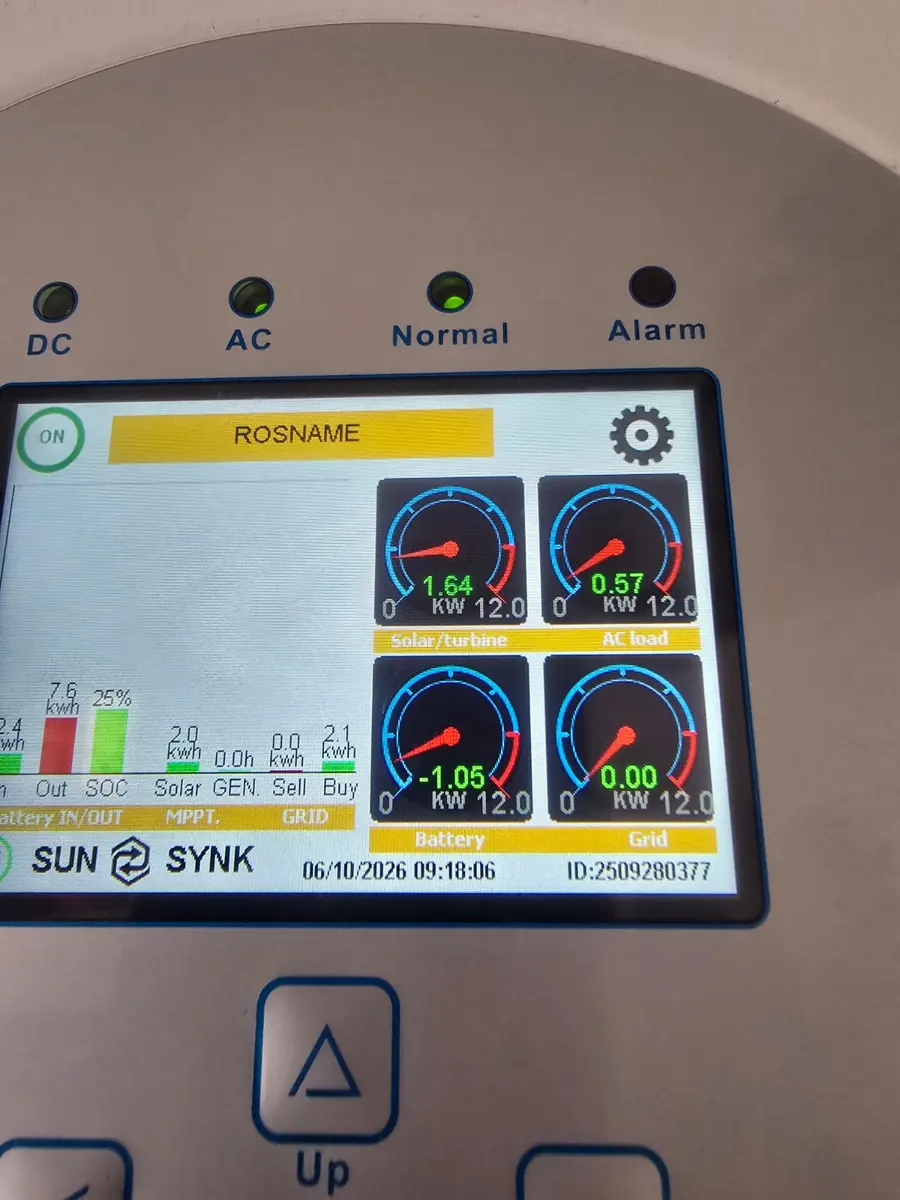

Sunsynk inverter screen with real-time solar, battery and grid readings
Real-time readings on a Sunsynk screen. The same data goes to the monitoring app on your phone.

Where we install. Electromech designs and installs solar and battery systems for homes and businesses across the East Rand — Boksburg, Benoni, Kempton Park, Germiston, Bedfordview, Alberton — and into Sandton, signed off by registered electricians with a COC. See our solar and renewable energy page or ask about an energy-saving assessment first if you want to cut usage before you size a system.

Frequently asked questions

Do I need a COC for a solar installation?

Yes. It is an alteration to your electrical installation and must be certified by a registered person. Insurers and the municipality will ask for it.

Can I install solar without connecting to the grid?

A backup-only or off-grid system is possible and avoids SSEG registration, but for most homes a grid-tied hybrid system gives far better value because the grid covers the days the sun does not.

How long does a home solar installation take?

A typical residential system is installed and commissioned in one to three days once the equipment is on site, longer if the DB board needs upgrading first.
